DESCRIPTION: AYAS 600 MW THERMAL POWER PLANT, PLANT'S LEVELING, EXTENSION OF EXCAVATION AND WAREHOUSE AREAS, IMPROVEMENT OF EXISTING STAFFES, KIZLARSUYU STREAM AND IT’S BRANCEHS, CONNECTION AND BRIDGE CONSTRUCTION
EMPLOYER: AYAS ENERGY PRODUCTION AND TRADE INC.
PLACE OF WORK: YUMURTALIK / ADANA
ESTIMATED COST: 25.319.696,50 USD
START DATE: 01.09.2009
DATE OF COMPLETİON: 1 1.06.2010
DURATION: 283 Days

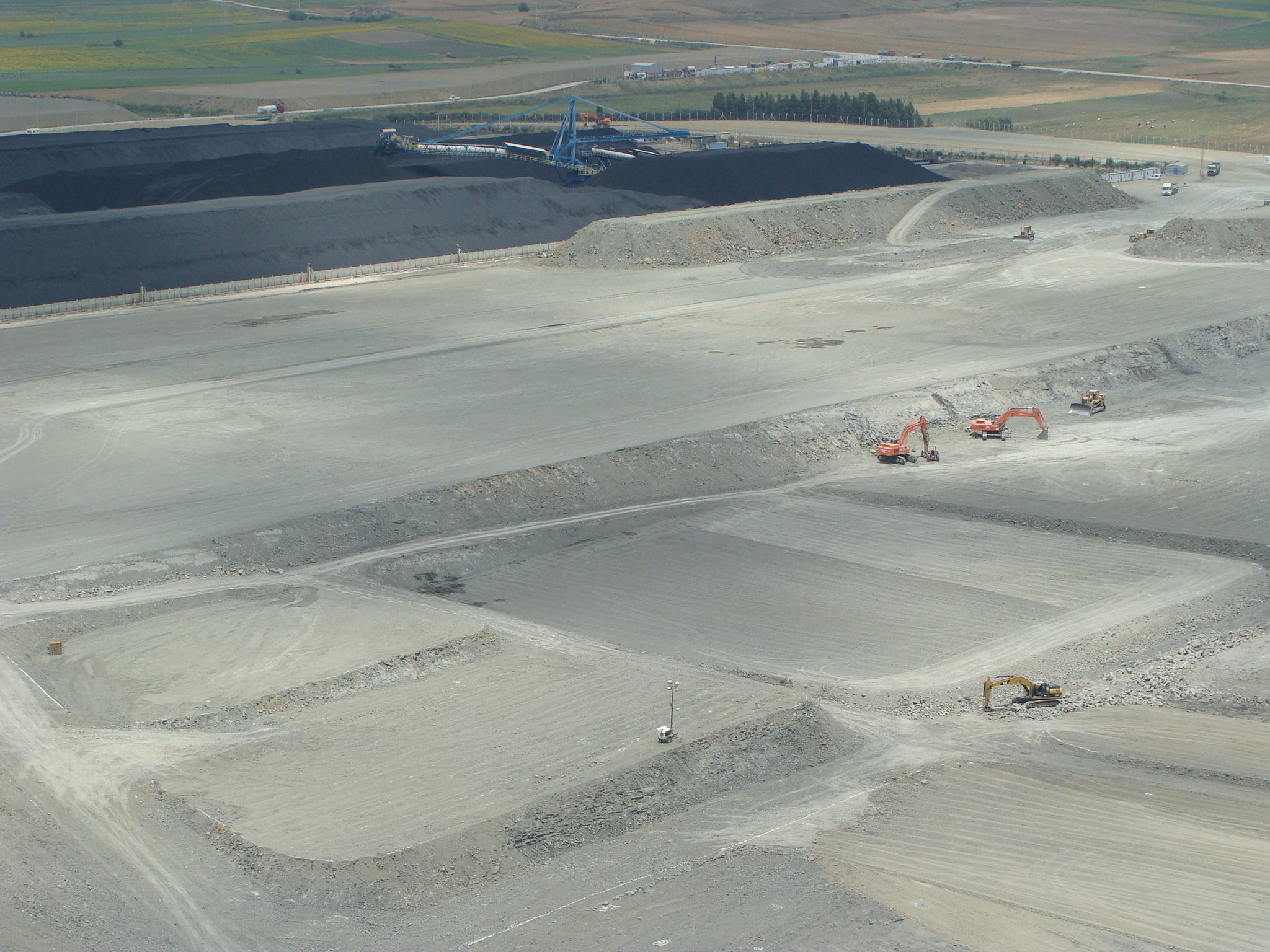

PROJECT CONTENT: 4 500 000 m3 of excavation and filling works, ground improvement of coal storage area; 55 000 m

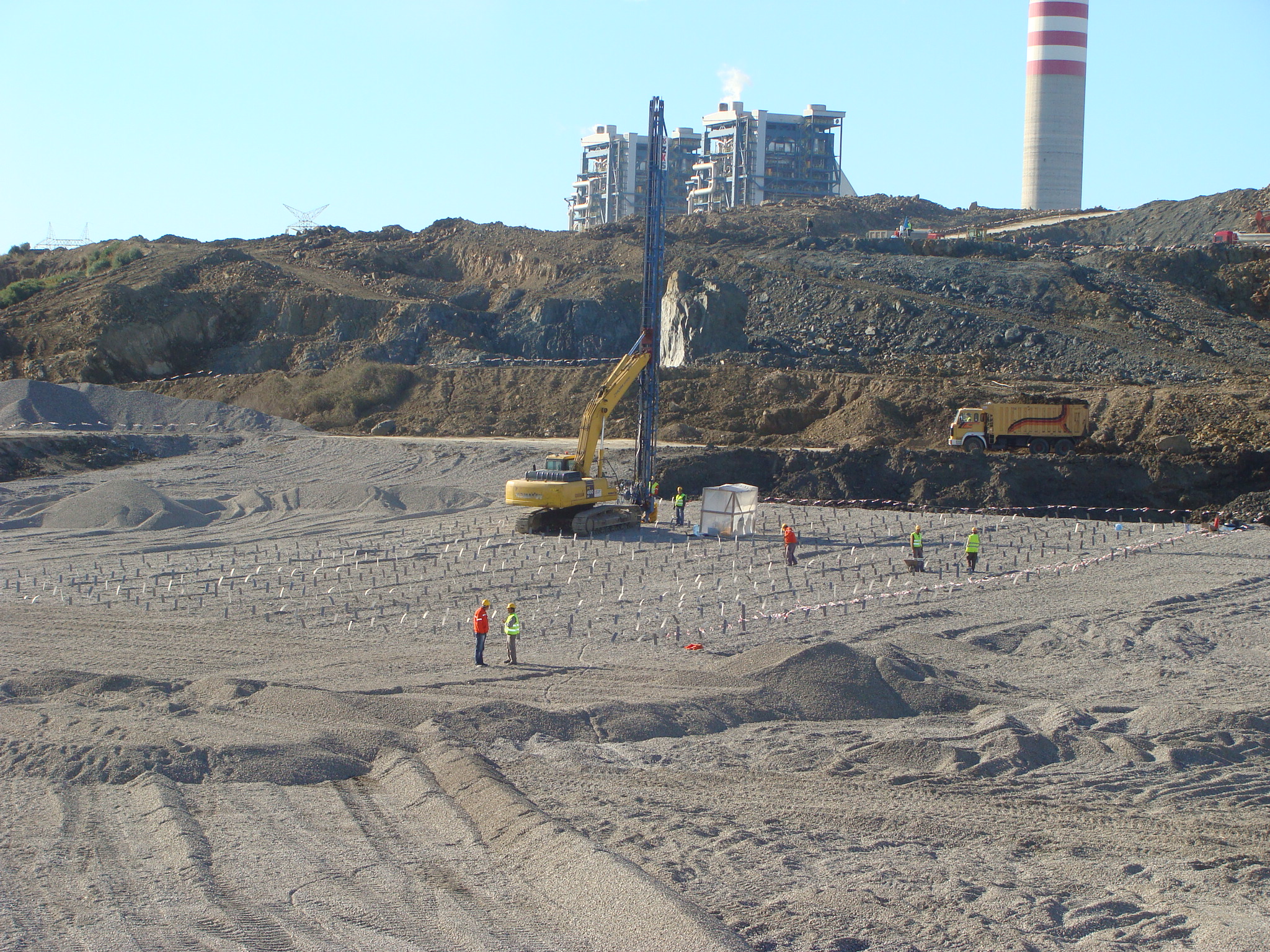

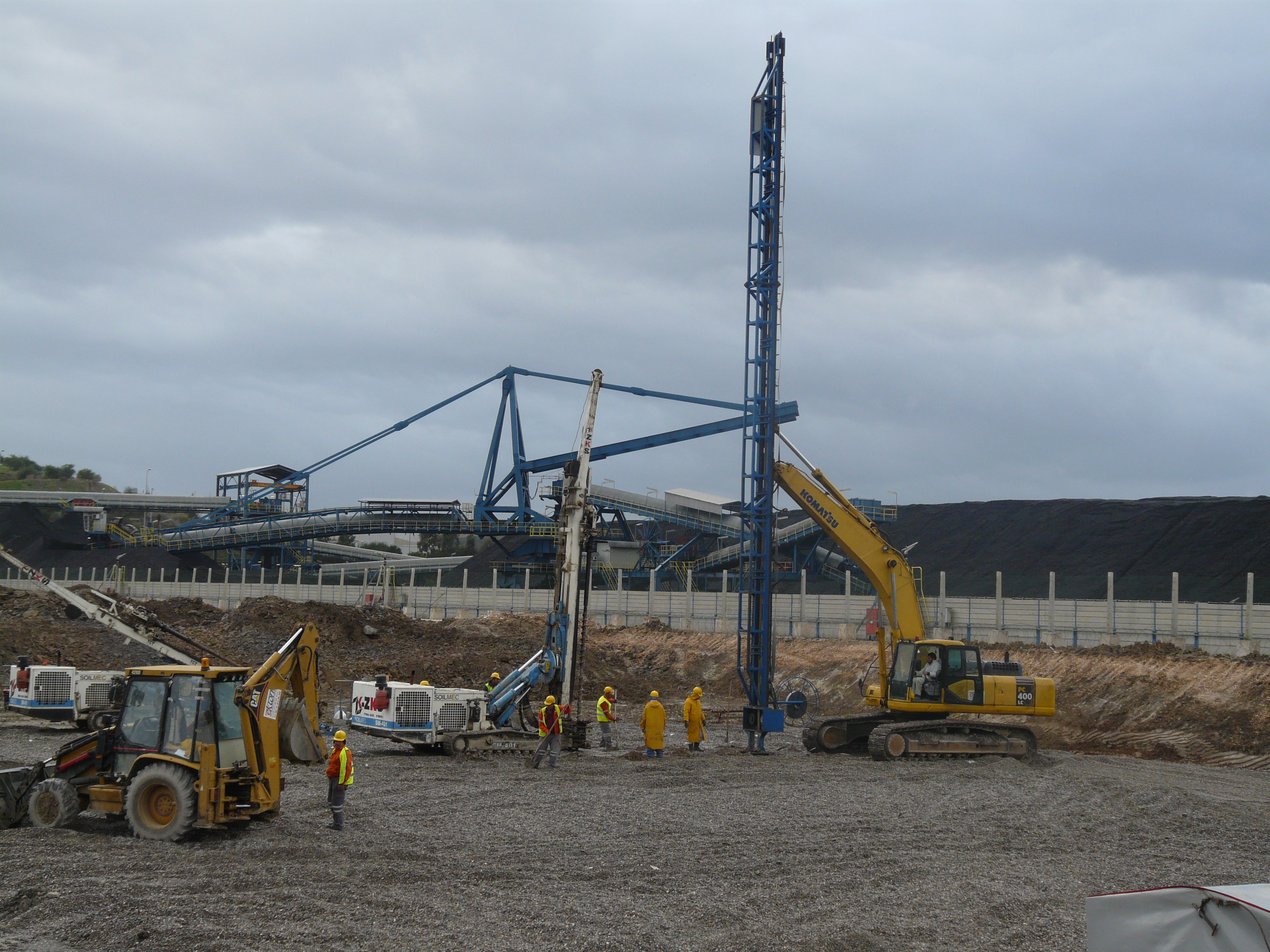

wick drain application with 150.000 m3 surgcharge process, reclamation of Kızlarsuyu Stream located

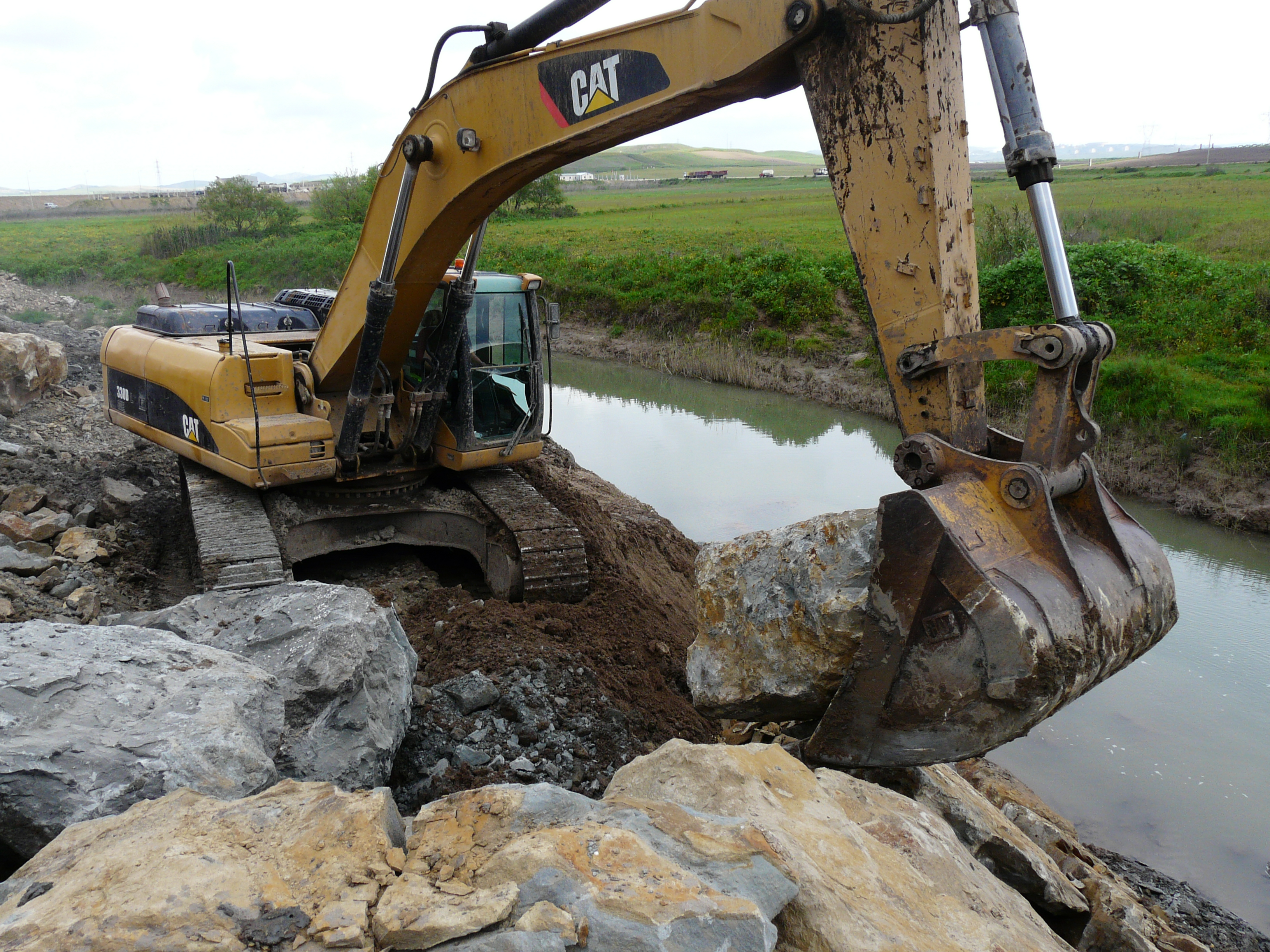

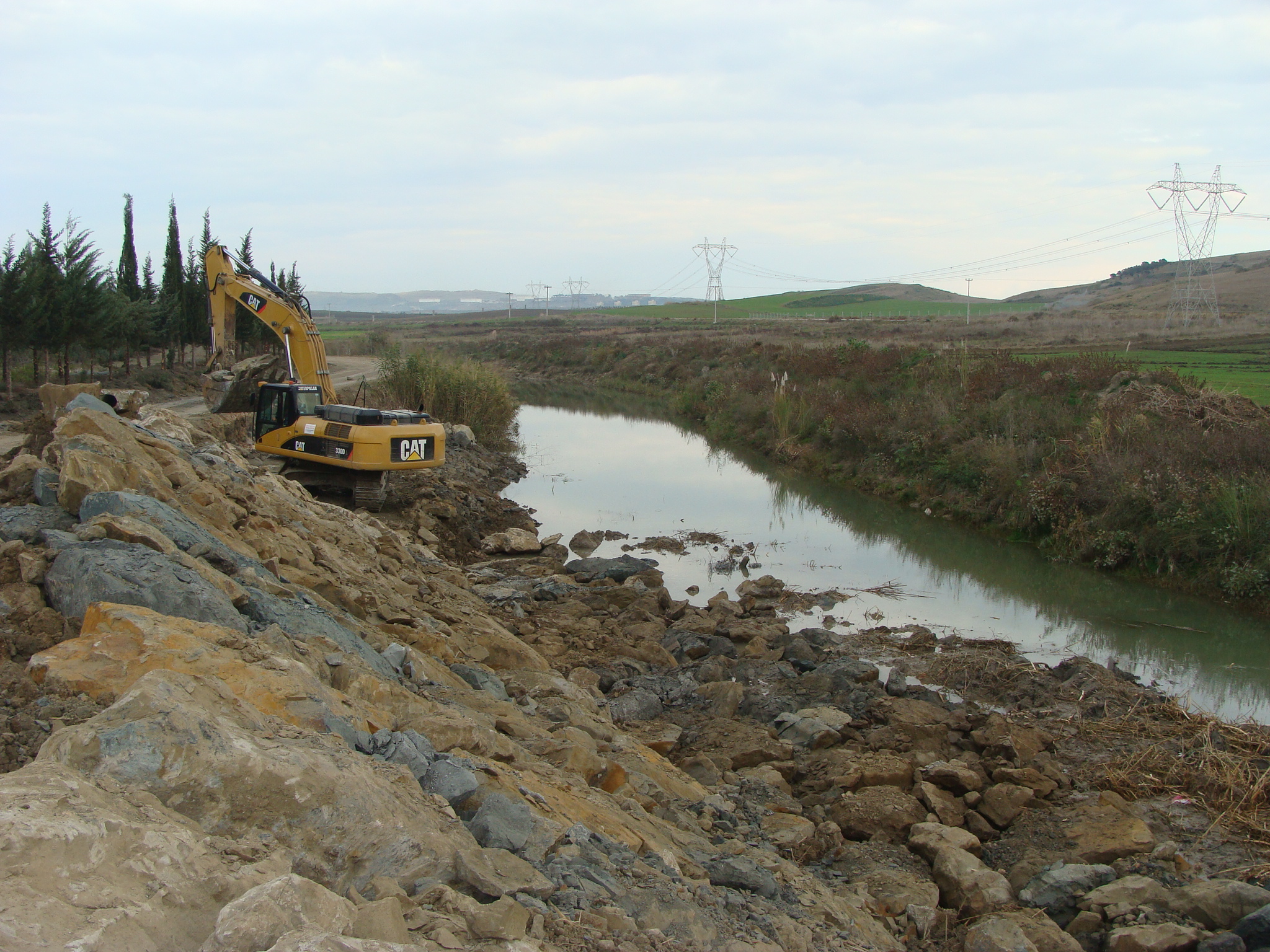

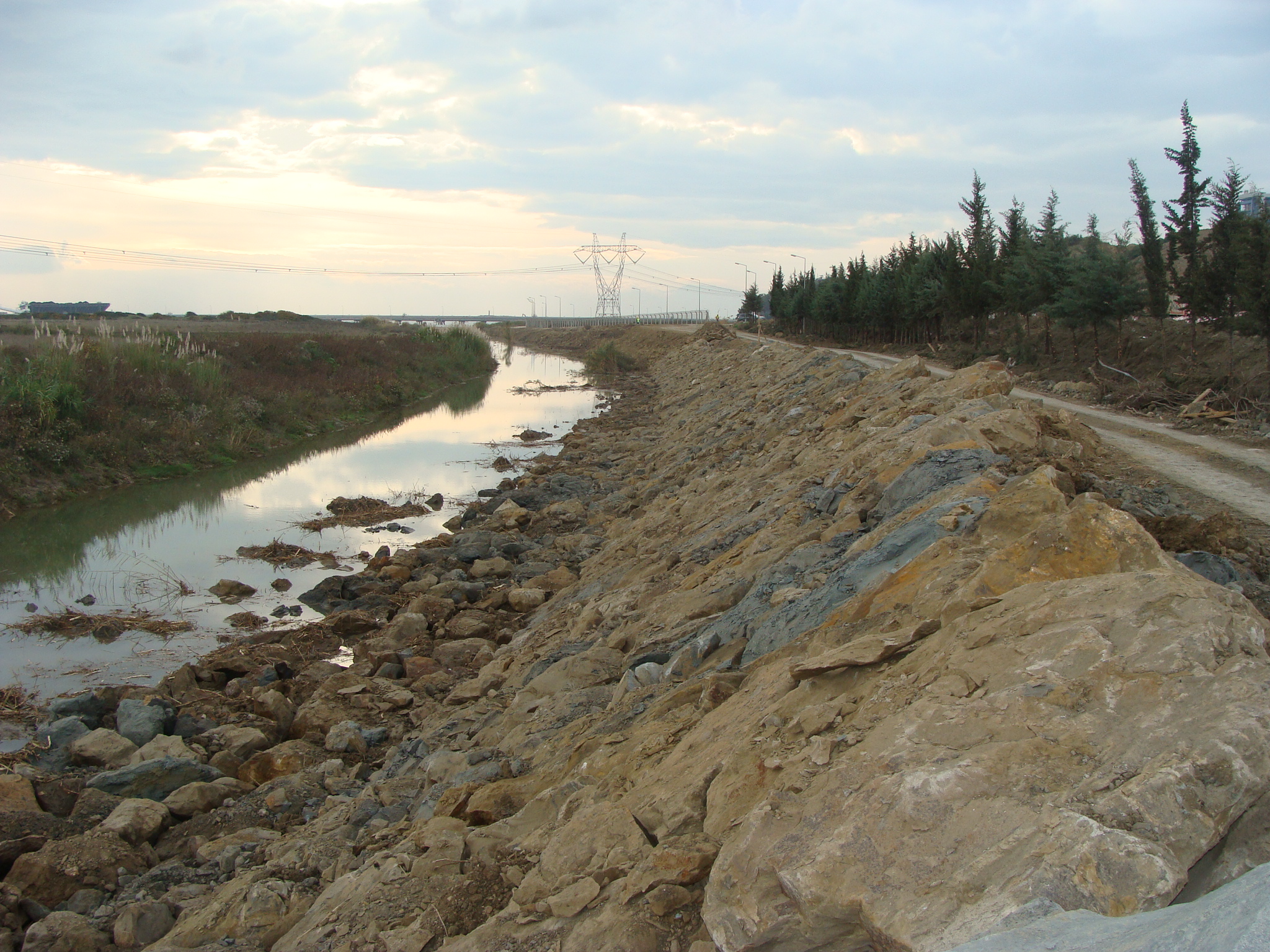

next to existing slopes and plant area; 3000 mt of retaining wall application, preparation of excavated
landfills, construction of central access road and bridge construction for the Levelling And Site

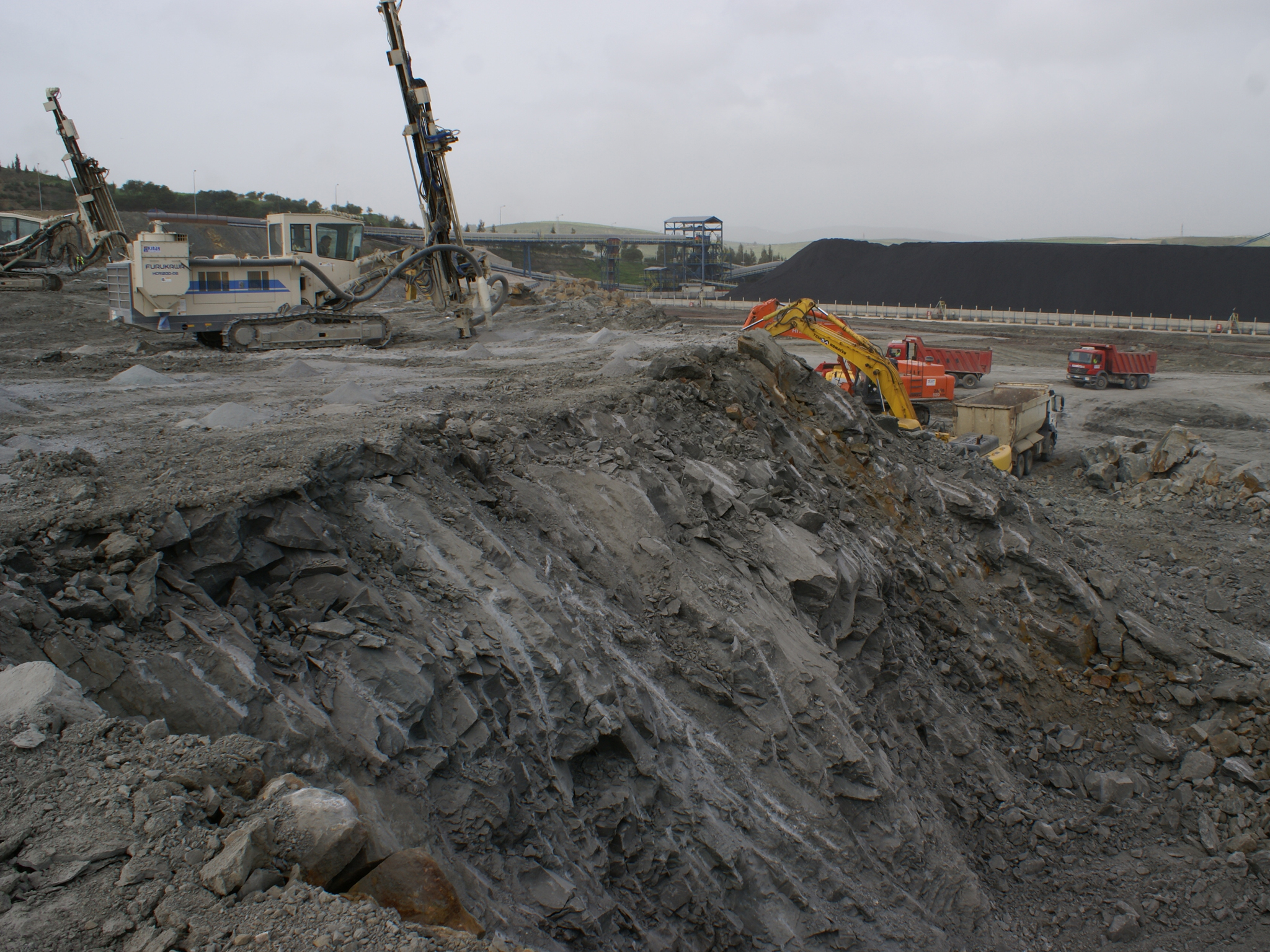

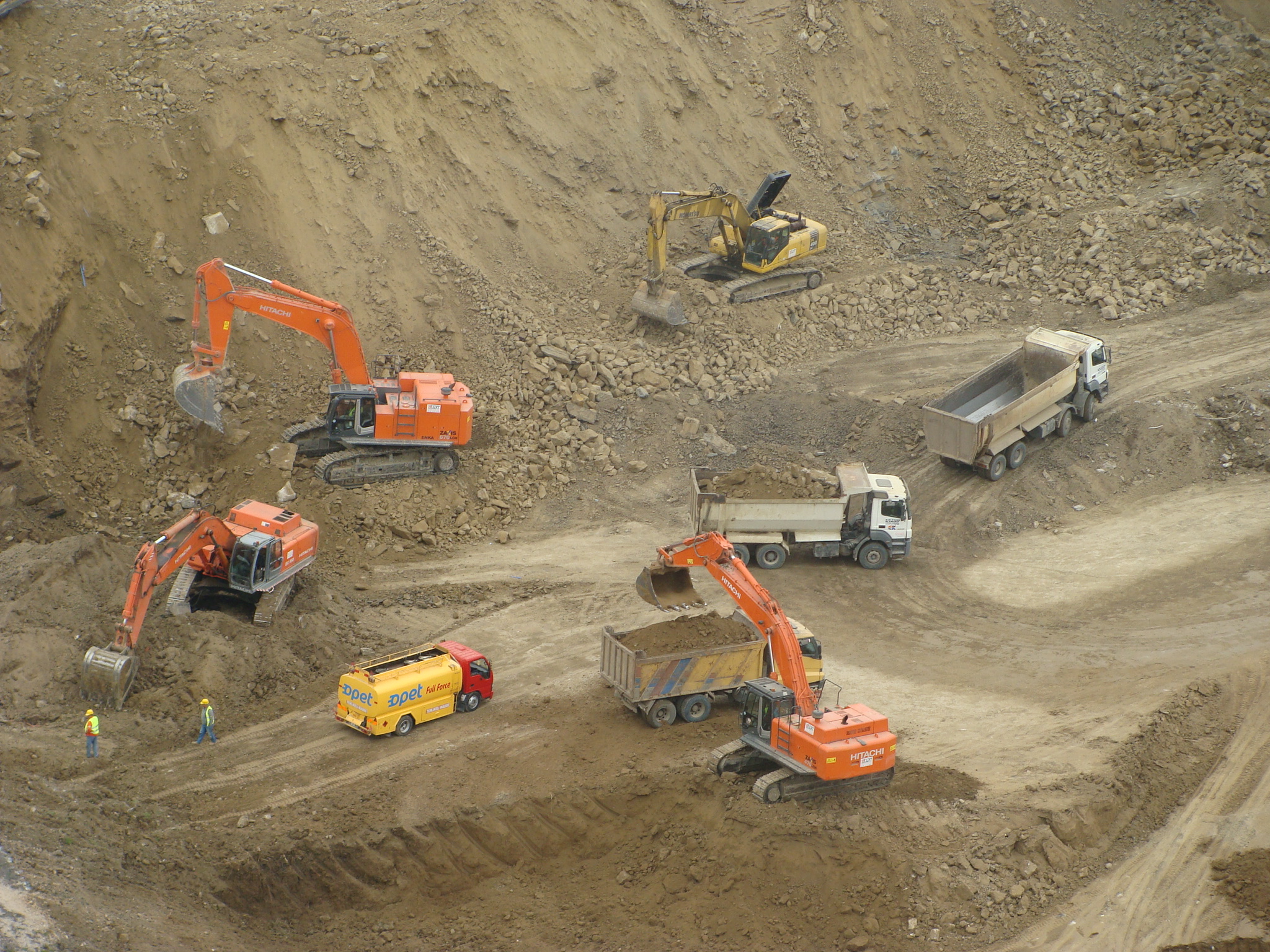

Preparation Works of AYAS-600 MW Coal Fired Power Plant. 2.500.000 m3 of excavation was carried

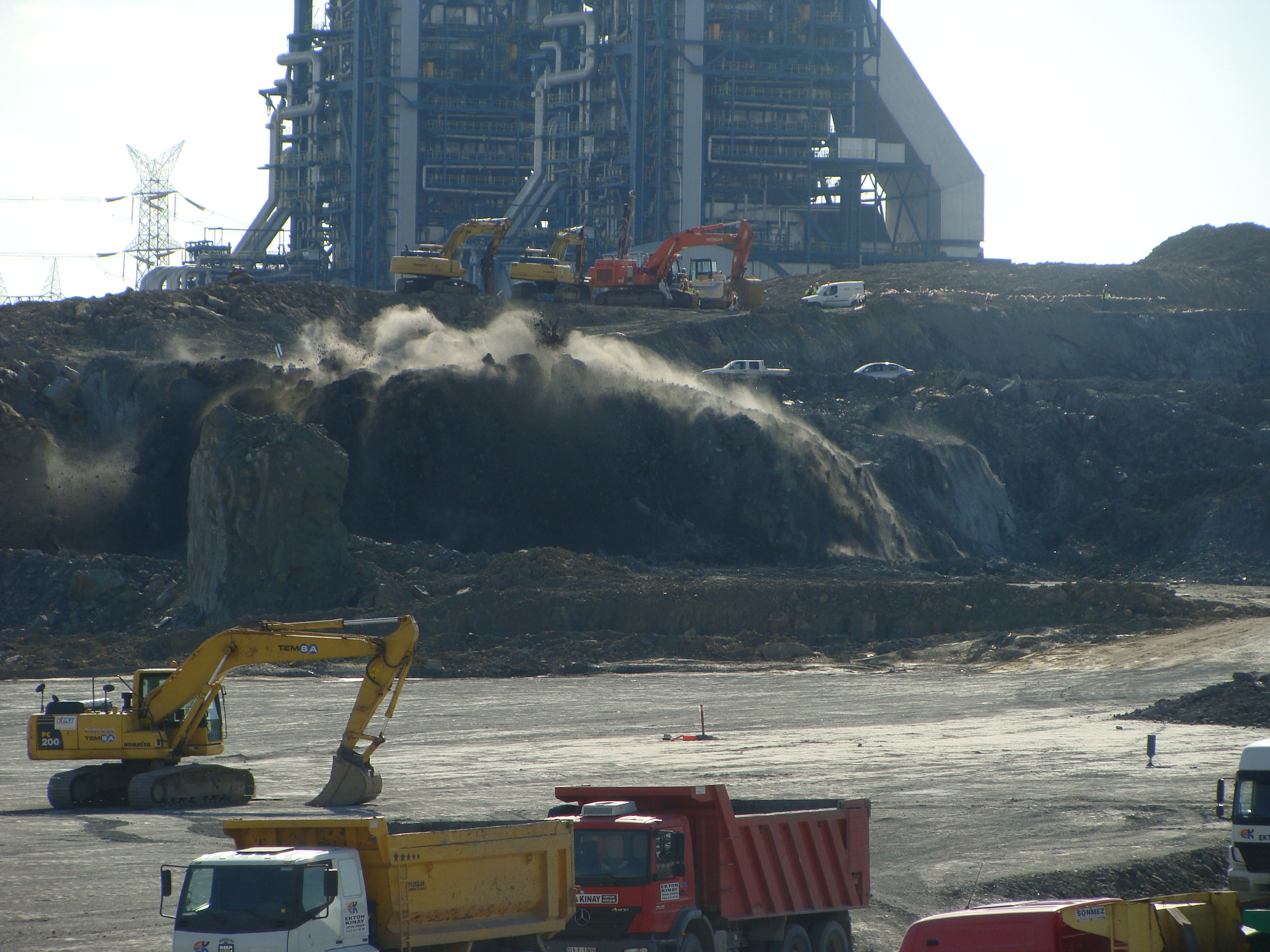

out with controlled blasting techniques. Vibration measurements were recorded for each blasting
round near the existing power plant.
